Three fire truck bids, three prices: bid leveling, options creep and change order costs

When a city or fire district puts a new apparatus out to bid, the assumption is simple: the same specification should produce roughly the same price. It rarely works that way. Three bids written against one RFP can come back tens or hundreds of thousands of dollars apart, and the gap usually has little to do with a manufacturer charging more. Most of it lives in the fine print — how each vendor reads the specification and what each one assumes the department actually wants.

For a fire chief, a procurement officer, or a finance director, the number on the bid tab is where the work starts. Take it at face value and the cheapest-looking truck is often the most expensive to own. Comparing bids honestly means bid leveling: normalizing every submission to the same scope so that real differences in price and value show up. It also means watching the two forces that push a budget past what was approved — options creep, the slow accumulation of discretionary features during the buying process, and change order costs, the charges that follow when scope is altered after the contract is signed.

Understanding how these three levers interact turns fire truck bids into a total-cost-of-ownership analysis instead of a single-number comparison. The sections below take each one apart, show where dollars get added or hidden, and explain how to judge an apparatus purchase when the money belongs to the public.

Why Bids for the Same Truck Rarely Match

To read a bid tab accurately, start with why the numbers diverge. Four structural factors usually explain the gap between the lowest and highest responsive bid.

  • Scope interpretation. Vendors read the same specification differently, and each bid reflects the reading its author chose. A line like “gross vehicle weight rating of at least 50,000 pounds” can send two bidders to very different chassis.
  • Standard versus optional equipment. What one builder includes as standard, another prices as an add-on. The bid can leave out items the department assumed were included.
  • Delivery and financing terms. Progress payments, escalation clauses, and lead-time guarantees carry real financial weight that a line-item price does not show.
  • Service, warranty, and parts commitments. Dealer proximity, warranty duration, and parts availability shape what the truck costs to run long after the invoice is paid.

Leave those four unaddressed and the comparison compares nothing. The rest of this article looks at the tools that make it useful.

What Is Bid Leveling in Fire Apparatus Procurement?

Bid leveling is the process of adjusting competing proposals to a common baseline so prices reflect equivalent scope instead of raw sticker numbers. Three bids with three different prices are rarely comparable, because each manufacturer packages its proposal its own way. One builder quotes a 1,500 GPM pump with a 750-gallon tank; another offers 1,000 GPM and 500 gallons. The lower headline price usually means less capability, not a better deal.

Only after normalization does bid evaluation mean anything. The leveling team lines up chassis class, pump rating, and agent capacity; delivery timelines; warranty length and exclusions; and included equipment such as hose, ladders, and rescue tools. Then it adds or subtracts line items until every proposal is measured against the same requirement list.

Delivery schedules carry real operational cost — a truck that arrives eight months late leaves a station uncovered. A broad warranty exclusion can erase apparent savings. An omitted hose complement does not disappear; it moves into a later change order.

How chassis class, pump rating, and agent capacity affect fire truck pricing is worth studying first, because it gives a committee the vocabulary to judge those differences. The result is a genuine like-for-like comparison, one that shows cost of ownership rather than the lowest number on paper.

Why Normalization Prevents Costly Surprises

A leveled bid set gives decision-makers a record they can defend. It shows why one proposal ranked above another, and it makes options creep harder, because scope that was never defined tends to grow after award. A transparent procurement keeps the specification tied to what the department actually needs and keeps the budget where it was set.

A minimal schematic flow diagram illustrating the bid leveling process as four connected stages: raw bid documents, a normalization funnel that aligns uneven inputs into uniform blocks, a row of identical comparable package boxes, and a balanced scale representing true cost comparison.

The diagram traces the process in four stages: raw bids come in as they are, get normalized into a common format, are grouped into comparable packages, and only then become a cost comparison. Each arrow is a step where the team removes an apples-to-oranges difference before trusting any dollar figure.

Normalizing Three Fire Truck Bids into a Comparable Framework

Three bids rarely arrive on equal footing. Before comparing a single dollar figure, normalize each proposal into one framework. Bid leveling means stripping away presentation differences so every offer is measured against the same apparatus specification.

Standardize these categories line by line:

  • Chassis class and axle configuration – cab/chassis model, gross vehicle weight rating, and 4×2 versus 6×4 axle layout
  • Pump capacity – rated flow in gallons per minute at the tested pressure
  • Water and foam tank size – usable volume for both water and foam concentrate
  • Aerial or ladder specifications – reach, tip load, and section count
  • Warning and lighting packages – lightbar output, siren type, and scene lighting
  • Safety systems – seat belts, airbags, stability control, and rollover mitigation
  • Delivery lead time – quoted months from award to delivery
  • Training – operator and maintenance hours included
  • Warranty coverage – years, component exclusions, and parts availability

When a low bid omits items, the omission looks like a price advantage. An underpriced pump or an excluded training package is cheaper today and a change order later. For sizing details, see fire truck pump capacity. Rebuild every bid against one master specification before you score it.

Specification Category Bidder A Bidder B Bidder C Leveled Adjustment Notes
Chassis Class Commercial (33,000 lb GVWR) Commercial (33,000 lb GVWR) Custom (44,000 lb GVWR) Commercial chassis clears the minimum spec; C’s upgraded custom cab earns no credit because the floor is commercial.
Pump Rating 1,250 gpm single-stage 1,250 gpm single-stage 1,500 gpm two-stage Ratings normalized at 10 ft lift per NFPA 1901; no adjustment taken for C’s higher flow since 1,250 gpm is the floor.
Tank Capacity 750 gal 500 gal 750 gal B’s 500 gal tank falls short of the required 750 gal, adding $14,800 to bring it up to spec.
Aerial / Ladder Reach 100 ft 75 ft 100 ft B’s 75 ft ladder misses the 100 ft minimum; the compliant substitute bid adds $52,000.
Warning & Lighting Package Full LED, traffic advisor Base NFPA package, 2 speakers Full LED, traffic advisor B’s base package leveled up to compliant LED and siren coverage, adding $9,600.
Delivery Timeline 24 months 30 months 26 months B’s 30-month build leaves the front line uncovered for six extra months, valued at $46,000 in reserve-unit costs.
Warranty 3 yr comprehensive 1 yr bumper-to-bumper 5 yr structural / 2 yr powertrain Leveled to the required 5 yr structural floor: A + $8,000, B + $12,000; C already meets it.
Training & Support 16 hr on-site 8 hr on-site 16 hr on-site B leveled to the 16 hr minimum, adding $3,200.
As-Printed Price $712,000 $648,000 $735,000 B carries the lowest headline price, $64,000 below the next-lowest bid.
Leveled True Cost $720,000 $785,600 $735,000 After $137,600 in leveling adjustments, B’s headline advantage reverses and it becomes the highest true cost; A, not the cheapest headline, emerges as the lowest.

What Is Options Creep and Why Does It Blow the Apparatus Budget?

Options creep is the gradual accumulation of add-ons during specification and negotiation. Each line item looks reasonable by itself; together they push the delivered price well past the figure everyone agreed to at the start.

It usually starts innocently. The department moves up to a higher-flow pump “since we’re already building it.” Then come extra compartment lighting, a bigger generator for scene equipment, communications upgrades, premium seating for long shifts, collision avoidance or supplemental airbags. Any one of those is easy to justify. The total can reach tens of thousands of dollars.

How Small Decisions Become Big Numbers

Timing is what makes it dangerous. As bids are leveled and negotiations tighten, “while we’re at it” offers surface in every sales conversation. Without disciplined apparatus budget management, nobody adds them up against the approved amount. By signing, the specification has drifted.

Customization is legitimate and often necessary; it still needs a rule. The committees that handle it well freeze a baseline, put a dollar threshold on any change, and require written approval before an addition proceeds. That is what separates a truck that fits the budget from one that forces a supplemental appropriation mid-cycle.

Our fire truck customization budgeting breakdown covers how to keep specifications and spending aligned.

Even a tight specification grows once a committee starts comparing upgrades, which is why budgeting a new fire truck comes down to watching every added line item. The most common options creep items cluster in these categories:

  • Pump and foam system upgrades – higher-flow pumps, CAFS, and foam proportioning can each add five figures.
  • Enlarged water/foam tanks – every extra gallon raises weight, chassis class, and total price.
  • Aerial and ladder enhancements – longer ladders, platform options, and outrigger upgrades push costs up sharply.
  • Warning and lighting packages – LED emergency lighting and traffic advisors add moderate but compounding cost.
  • Communications and CAD integration – mobile data terminals, radios, and CAD links rarely come standard.
  • Generator and electrical upgrades – larger generators and extra outlets increase both base and installation cost.
  • Seating and crew comfort additions – upgraded seats, HVAC, and storage quietly inflate the build.
  • Extended warranty or service plans – coverage extensions add predictable but recurring line items.

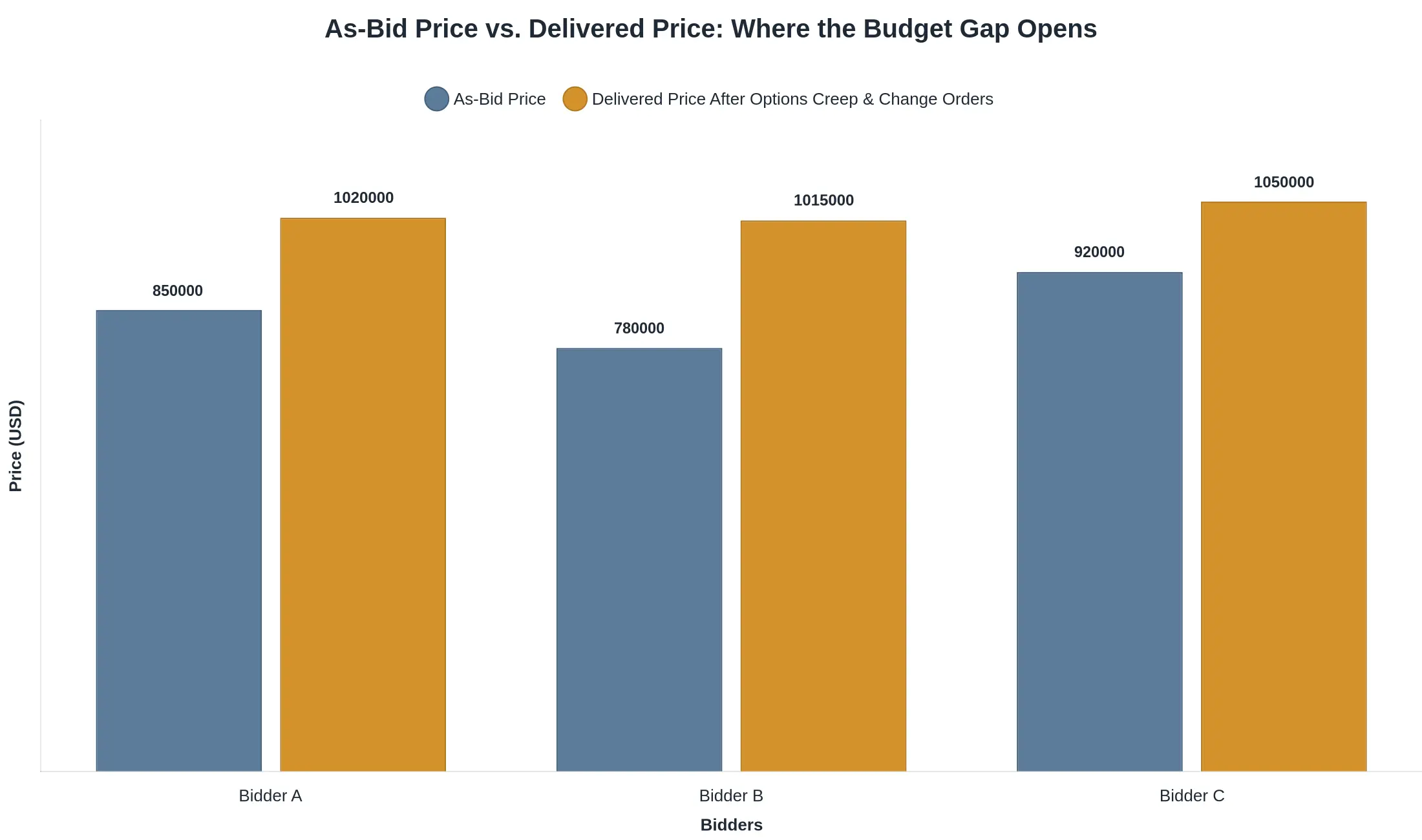

Grouped bar chart comparing the as-bid price and delivered price for Bidder A, Bidder B, and Bidder C, showing how options creep and change orders widen the final budget gap.

The bid price is a promise; the delivered price is the bill. Across these three trucks, options creep and change orders widen the gap to six figures, and Bidder B’s final gap is more than double its apparent advantage. Budget on the delivered number, not the sticker from bid opening.

Simple 2D schematic showing change order costs accumulating as stacked incremental blocks rising in step formation along a horizontal build timeline

Strategies to Control Options Creep and Change Order Costs

Options creep rarely announces itself. It arrives as a series of small “while we’re at it” additions, long after the winning bid was approved. The only reliable defense is discipline before the solicitation goes out.

Lock specifications before bid release. Once the document is frozen, every manufacturer bids against the same baseline. That is what makes leveling a comparison instead of a guessing game, and it removes the ambiguity that later turns into a dispute.

Rank features as “must-have” or “nice-to-have.” Agreeing on that list in advance gives the committee a defensible way to cut when the numbers climb, instead of arguing over add-ons in a review meeting.

Build a contingency line into the budget. Reserve a fixed percentage for legitimate mid-build changes so a surprise does not force an emergency appropriation. Our fire truck customization budgeting guidance can help size that reserve.

Require detailed change order pricing upfront. Any change should be quoted with labor, parts, and schedule impact before approval, so change order costs stay visible and negotiable.

Hold structured post-award reviews. Debrief each change to find the recurring drivers and tighten the next specification.

Frequently Asked Questions: Fire Truck Bids and Final Costs

What exactly is bid leveling in fire truck procurement?

It is the process of normalizing competing bids so they can be compared like for like. Vendors structure base pricing, specifications, and optional features differently, so each proposal has to be aligned to a common scope before any cost comparison means anything. Without leveling, the lowest number often hides gaps in equipment, warranty coverage, or performance that raise the real price later.

How does options creep affect the final fire truck price?

It is the slow addition of upgrades and features as stakeholders review a specification line by line. A modest list of “nice-to-haves” can add tens or even hundreds of thousands of dollars to a build. No single option seems large; the cumulative effect pushes the delivered price past the original budget.

Why do change order costs occur after a contract is signed?

They occur when scope shifts after the contract is signed — a late specification revision, an evolving NFPA standard, a chassis availability problem. Once production has started, even a small modification runs through engineering, materials, and labor schedules, and vendors price the disruption accordingly. The adjustments are legitimate; they are rarely cheap.

How can a department keep the delivered price close to the budgeted price?

Freeze specifications early and level the bids before award. Reserve a contingency line, and use a detailed new fire truck budgeting guide to account for customization, lead time, and service costs from the start. That is what keeps surprises, and change orders, to a minimum.

What Three Bids Really Tell You About the True Cost of a Fire Truck

Three bids with three different prices tell you very little until you level them. The lowest number looks like the obvious win; more often it hides a leaner base specification, weaker warranty terms, or a delivery timeline that raises the cost of ownership. The sticker price is where the analysis starts.

Two forces decide what you actually pay. Options creep turns a series of minor additions – a larger pump, an upgraded cab, extra lighting – into an apparatus well beyond the approved budget. Change order costs add the premiums, rework, and schedule delays that follow decisions made after signing, none of which the initial bid captured.

Bid leveling exposes the gaps by measuring every proposal against one specification. Options creep and change order costs explain why the winning bid and the final invoice rarely match.

Public money is protected by two habits: defining requirements precisely before the solicitation, and controlling scope after award. For the cost variables behind chassis class, pump rating, and agent capacity, see this breakdown of what drives the price of a new fire truck.

Informed procurement comes down to leveled bids, controlled options, and disciplined change management. Departments that get those right do not just buy trucks; they end up with dependable apparatus and a budget that holds.
